Planning

Most Recently Approved RTEP Updates
transmission-under-construction

122 New Projects

5 Project Scope/Cost Change

0 Project Cancellations

Learn How PJM Plans the Future

Competitive Planning Process
  • The PJM competitive planning process affords non-incumbent transmission developers an opportunity to participate in the regional planning and expansion of the PJM bulk electric system.
  • 2026 RTEP Window 1
     open7.20.2026 closed10.12.2026
Planning News from Inside Lines
  • PJM Board Approves Transmission Project Changes to Support Grid Reliability
    The PJM Board of Managers has authorized changes in scope and cost to some baseline projects in its Regional Transmission Expansion Plan (RTEP) to help provide the most efficient, economical and reliable supply of power for the 67 million people PJM serves across 13 states and the District of Columbia. The most significant scope/cost changes […]
  • PJM Plan Would Cut Interconnection Process Time in Half
    PJM has developed a new process designed to cut in half the time it takes to study new power generation and transmission service for large electricity users, including data centers. The Fast Energization process reduces projected timelines from two years to one and addresses the ongoing shortfall in new generation resources that is driving up […]
Generation Interconnection Requests by Fuel Type
(Active projects only)
As of 6:10 a.m. EPT

Projects Under Construction by MW
As of 6:10 a.m. EPT
Total:
46,963 MW

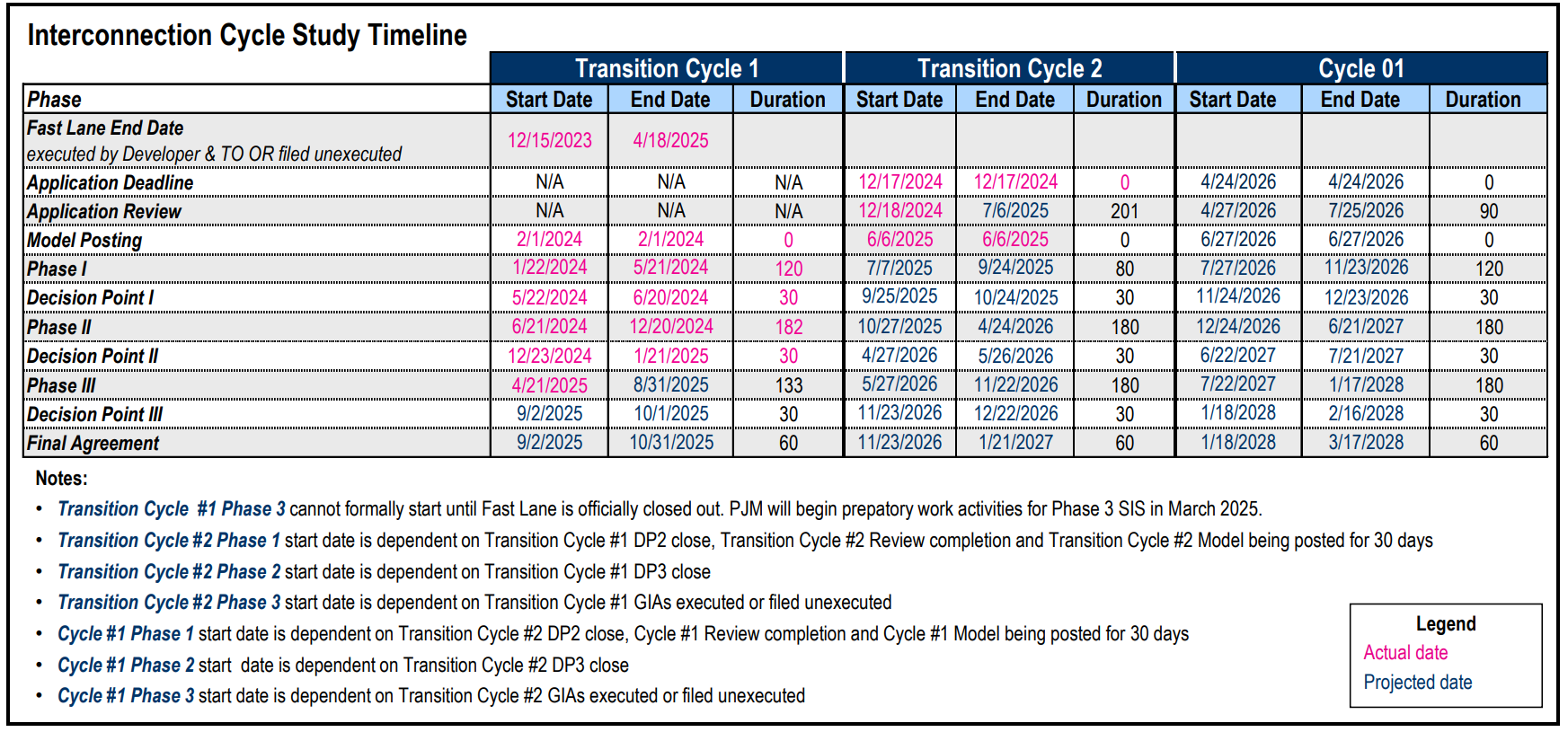

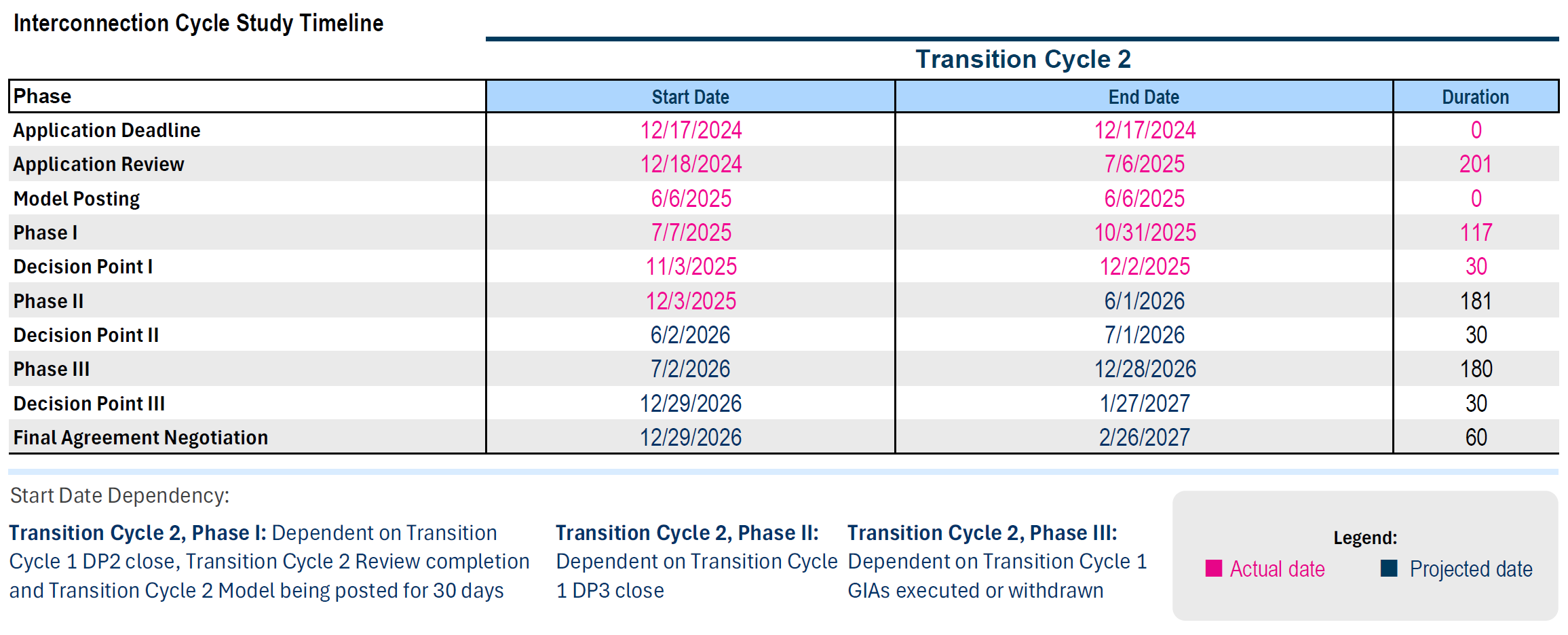

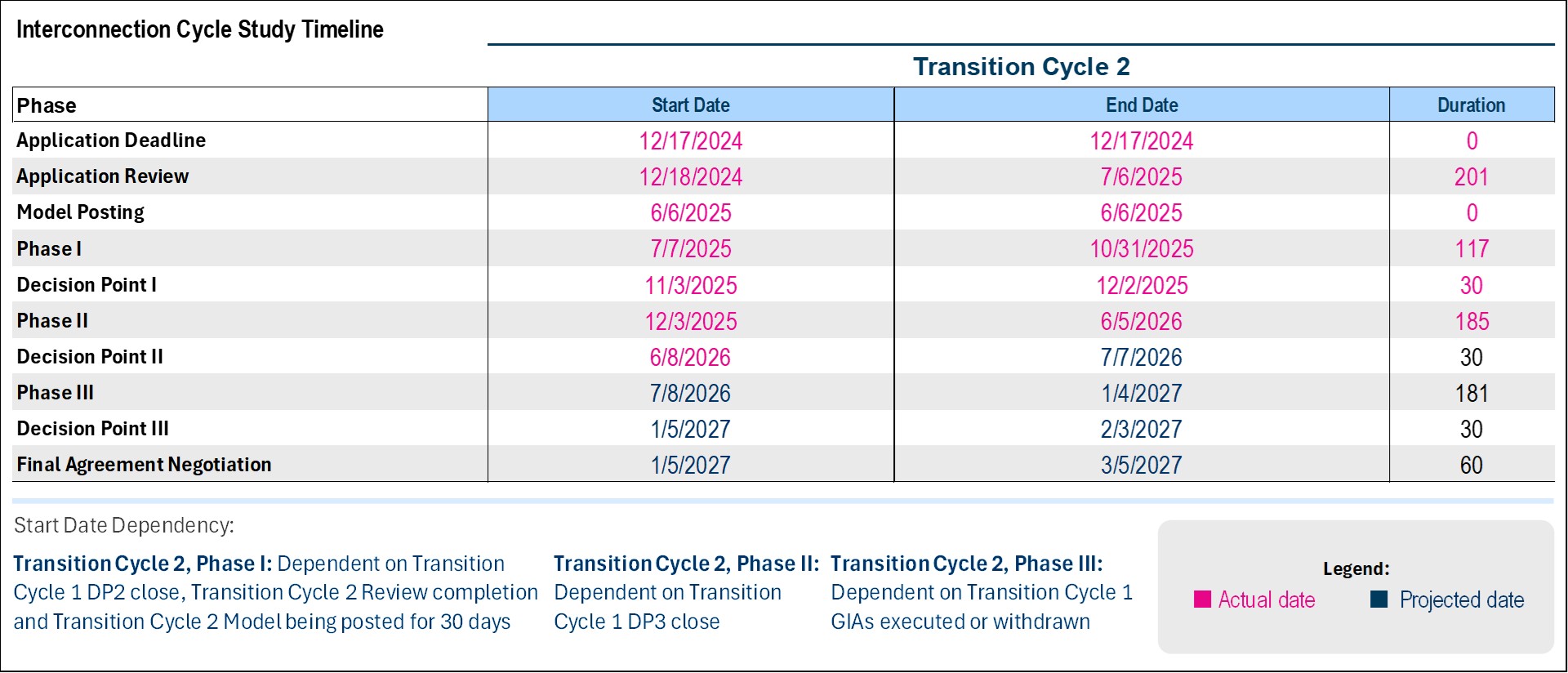

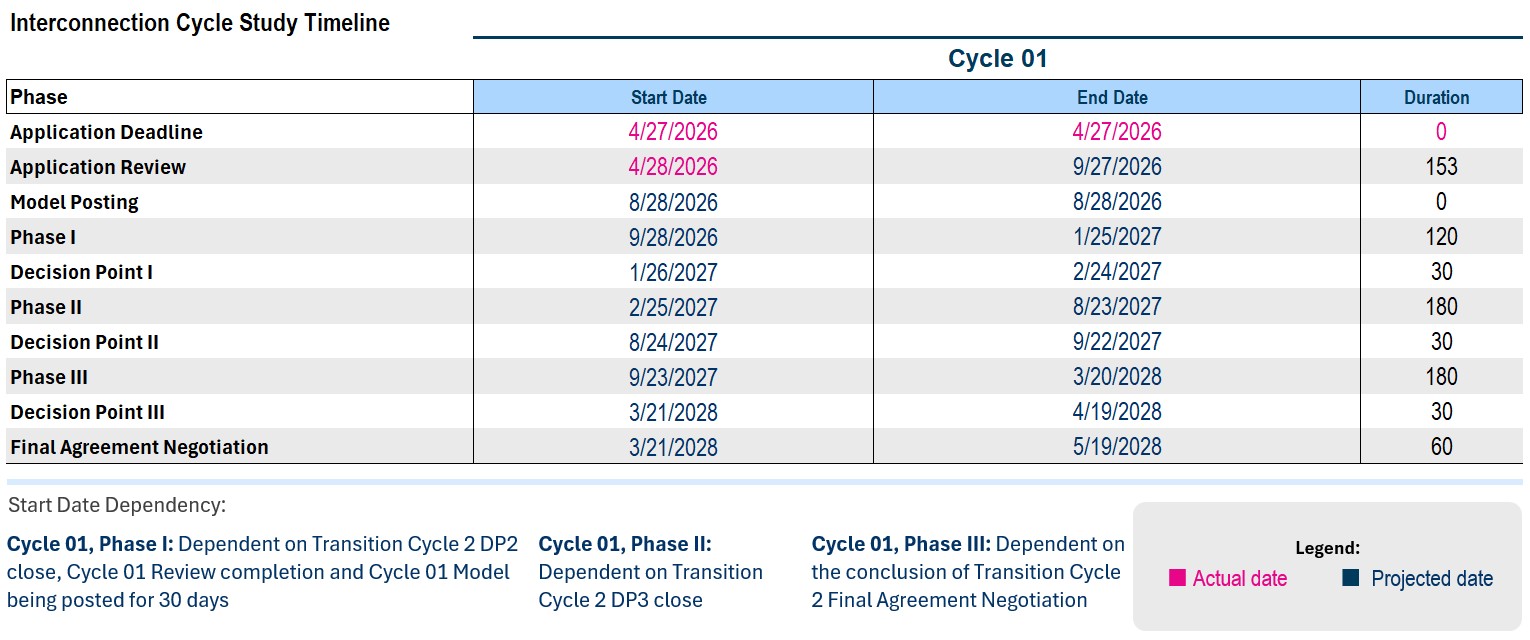

Cycle Timeline
As of 10.23.2026 12:03 p.m. EPT
Select Cycle
